Cross Project Predecessors for Tasks - Pros & Cons

  • September 19, 2023
  • 1 reply
  • 1043 views

Our operations team is exploring the Cross Project Predecessors feature for a possible use case.



I have taken a look at the pages below but wanted to ask this group if there are any pros/cons you have encountered using this setup.



https://experienceleague.adobe.com/docs/workfront/using/manage-work/tasks/use-task-predecessors/cross-project-predecessors.html?lang=en

https://experienceleague.adobe.com/docs/workfront-learn/tutorials-workfront/manage-work/intermediate-projects/understand-cross-project-predecessors.html?lang=en



Thank you in advance.

This post is no longer active and is closed to new replies. Need help? Start a new post to ask your question.
Best answer by KristenS_WF

Cross-project predecessors are a necessity for us for certain product lines.



A few years ago, we split the development of our core annual learning products into front-end and back-end projects.  The front-end projects (or modules) contain content development tasks (writing, copyediting, etc.), and each project is akin to a book chapter.  The back-end projects (or deliverables) are the for-sale formats of a course and feature different workflows depending on the format.



We use cross-project predecessors to link the modules and deliverables.  So, we may have course family AAA, with 8 module projects: AAA24-01, AAA24-02, etc.  The Course 1 deliverable might be made up of content from all 8 modules, while the Course 2 deliverable might include mods 1-3, 5.



Having cross-project predecessors does enable us to know when the back-end deliverable projects can/should launch (the system we used prior to WF didn't have cross-project predecessors, and we had to manually track the mod/dev relationships to know when to launch the back-end projects).



Reporting is a bit challenging.  Because we have multiple back-end projects relying upon the same front-end modules (and because those back-end workflows can vary), we can't use a single milestone path across the front- and back-ends.  One workaround we've used is to create a task report (consisting of the back-end launch tasks where the cross-project predecessors reside) and use a collection to show the cross-project predecessors and their respective completion percentages).



1 reply

KristenS_WF
KristenS_WFAccepted solution
Level 6
September 19, 2023

Cross-project predecessors are a necessity for us for certain product lines.



A few years ago, we split the development of our core annual learning products into front-end and back-end projects.  The front-end projects (or modules) contain content development tasks (writing, copyediting, etc.), and each project is akin to a book chapter.  The back-end projects (or deliverables) are the for-sale formats of a course and feature different workflows depending on the format.



We use cross-project predecessors to link the modules and deliverables.  So, we may have course family AAA, with 8 module projects: AAA24-01, AAA24-02, etc.  The Course 1 deliverable might be made up of content from all 8 modules, while the Course 2 deliverable might include mods 1-3, 5.



Having cross-project predecessors does enable us to know when the back-end deliverable projects can/should launch (the system we used prior to WF didn't have cross-project predecessors, and we had to manually track the mod/dev relationships to know when to launch the back-end projects).



Reporting is a bit challenging.  Because we have multiple back-end projects relying upon the same front-end modules (and because those back-end workflows can vary), we can't use a single milestone path across the front- and back-ends.  One workaround we've used is to create a task report (consisting of the back-end launch tasks where the cross-project predecessors reside) and use a collection to show the cross-project predecessors and their respective completion percentages).



KierstenKollins
Community Advisor
Community Advisor
September 19, 2023

This is very helpful! Thank you!

Doug_Den_Hoed__AtAppStore
Community Advisor
Community Advisor
September 21, 2023



Hi @kierstenkollins,

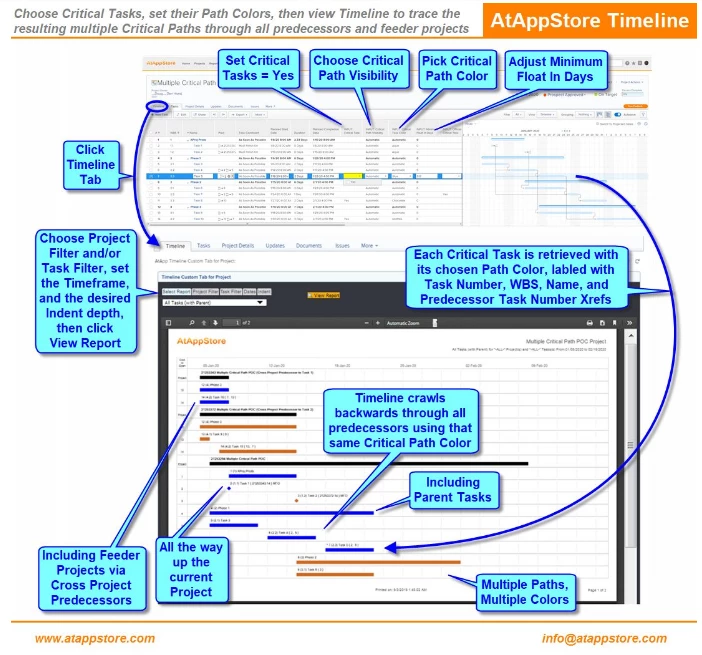

To the reporting challenges around cross project predecessors @kristens_wf  mentioned, I invite you to consider our Timeline solution, which lets you choose one or more Critical Tasks, set their Path Colors, then view Timeline to "crawl" the resulting multiple Critical Paths through all cross project predecessor feeder projects.





Regards,

Doug
